Time Square 6 (302) Project Construction Progress Report

Time Square 6 (302) is an ambitious project in the center of Cambodia’s capital Phnom Penh from proven developer MegaKim World Corp.

  • Premium segment
  • Multifunctional infrastructure of the facility
  • Location BKK1 – the capital’s business center
  • 49 floors, 370 apartments
  • 98% sold out

Construction stages:

  • August 30, 2023 – Laying of the foundation stone (first stage of construction)

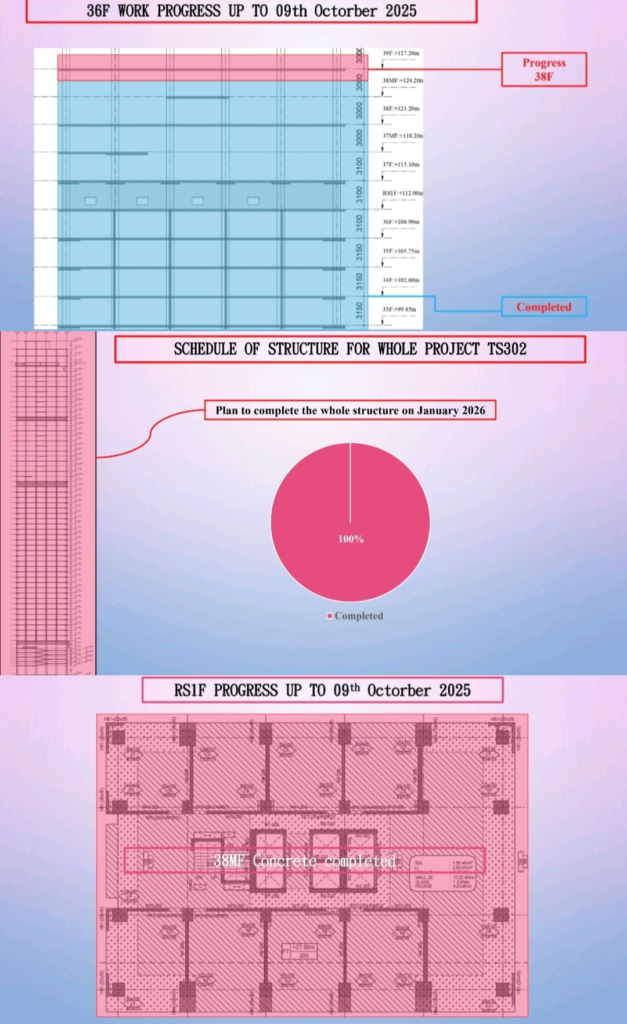

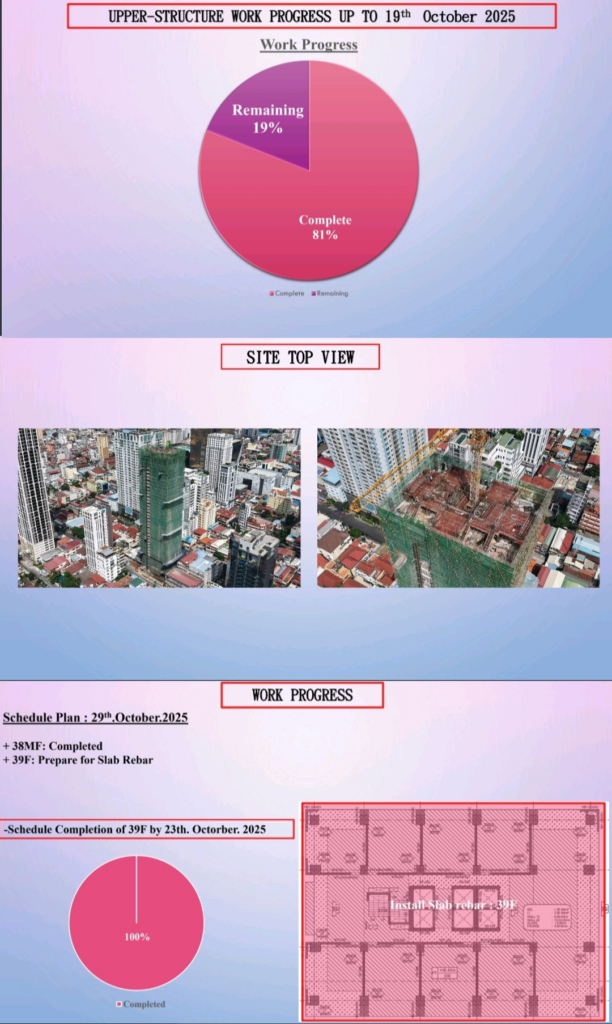

  • October 19, 2025 – The 38th floor is reported to be 100% ready.
  • October 29, 2025 – 39th floor is ready
  • January 2026 – facility building readiness plan
  • Q3 2026 – facility handover and key collection

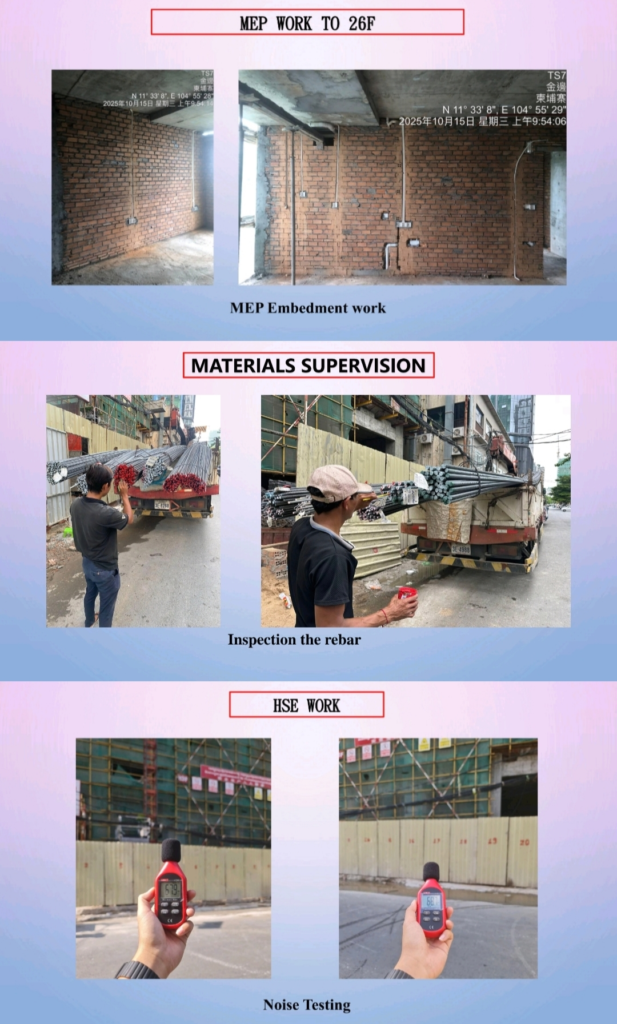

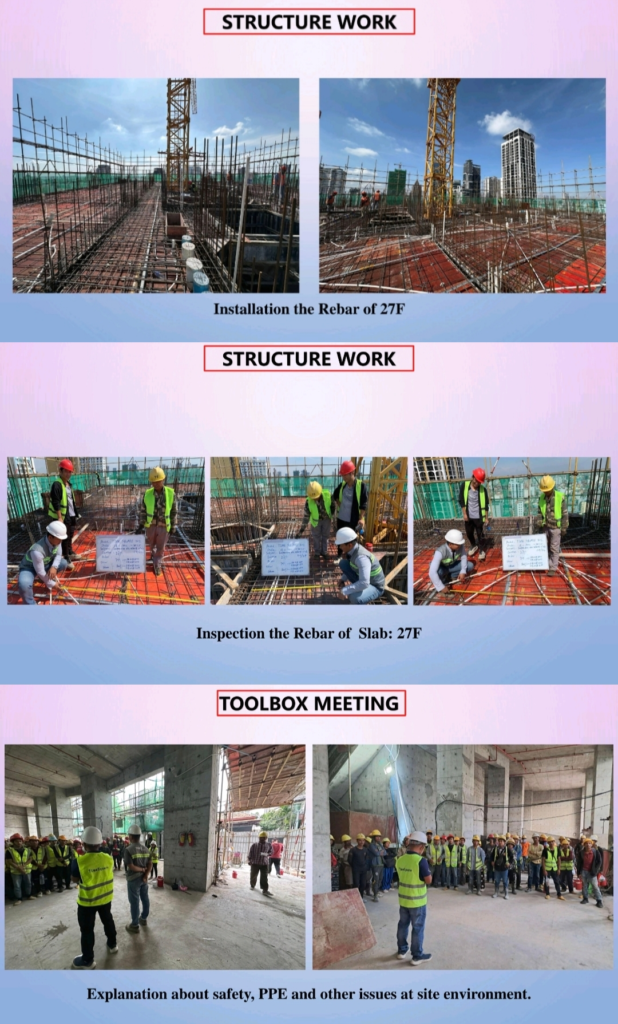

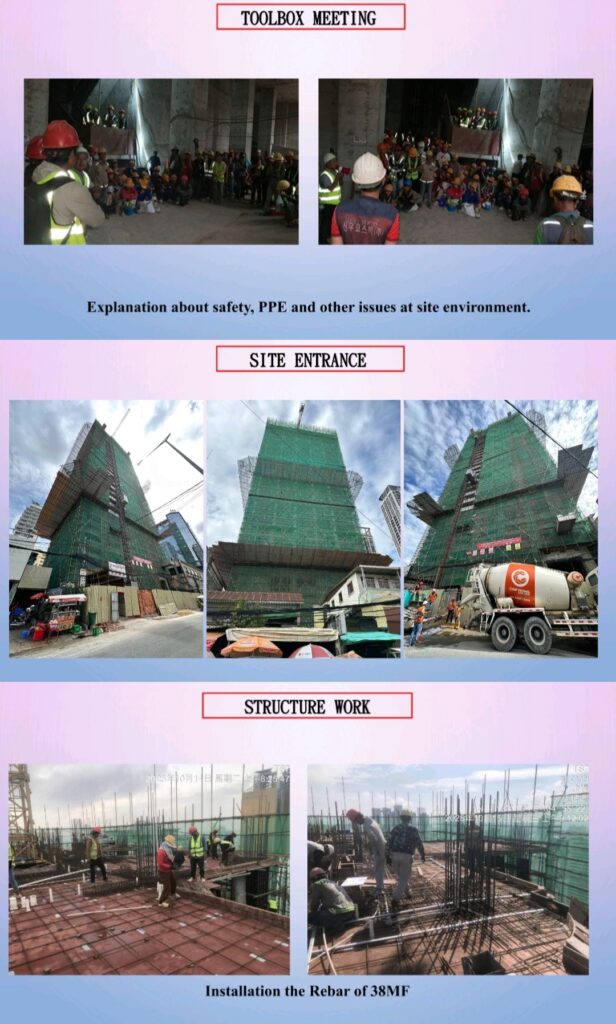

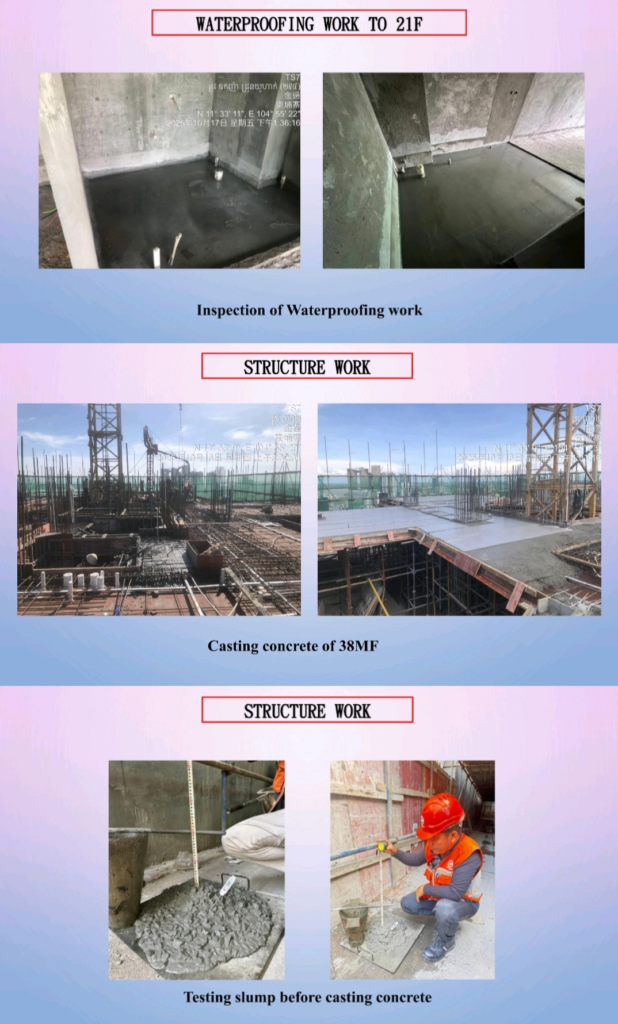

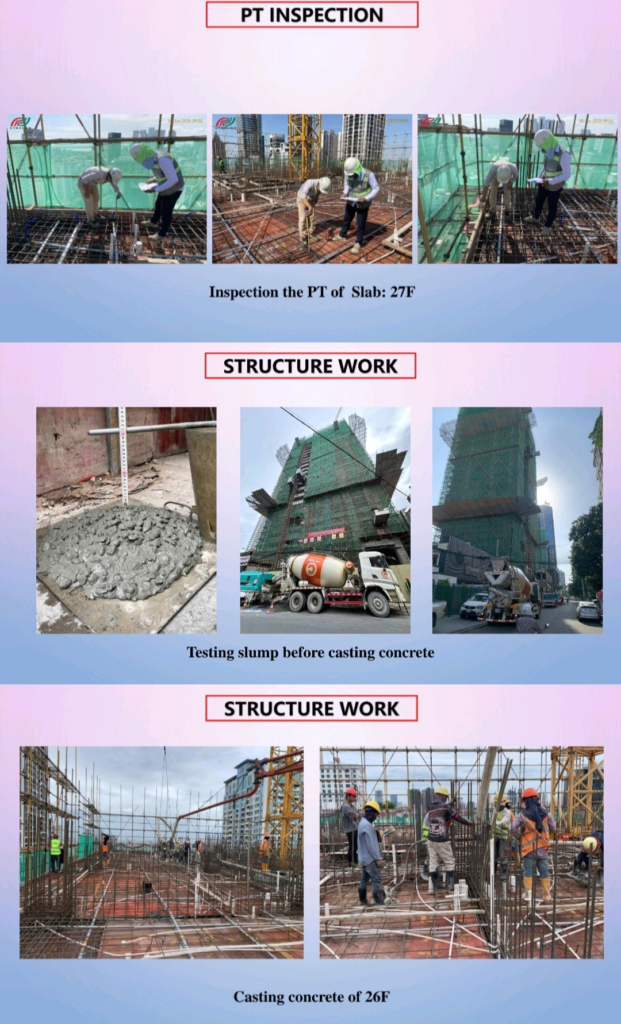

Developers provide monthly construction reports, keeping our clients up to date.
The progress of the construction of the Time Square 6 (302) project / october 2025 download:
The progress of the construction of the Time Square 6 (302) project / june 2025 download:
